Bath City Centre active travel plans

Update, November 2026

Overnight resurfacing works will take on an extended area of Monmouth Street for three consecutive nights, from Monday 9 November to Wednesday 11 November, 11pm to 6am. See our weekly construction updates for more.

Works to resurface the junction of Charles Street/James Street West/Green Park Road will take place across three consecutive nights, from Wednesday 11 November to Friday 13 November, between 11pm and 6am each night. Click here to view more information.

Use this page to find out about the proposed improvements to the walking, wheeling and cycling links in Bath City Centre.

Project and strategy context

Bath City Centre aims to improve walking, wheeling and cycling in the historic city, as well as address improvements to bus services. Both will enable more travel choices, healthier places and people, and greater connectivity in and out of the city centre.

Since public consultation in 2023, the project has been divided into phases. The first phase concentrates on walking, wheeling and cycling improvements. Phase 2 looks at implementing bus infrastructure improvements aimed at providing better journey times and reliability.

It is one of several CRSTS (City Region Sustainable Transport Settlements) projects being developed in Bath. It will work alongside other transport strategy initiatives in the city to support our community's travel choices.

The proposals were subject to a formal Traffic Regulation Order (TRO) consultation in 2025 and a decision was made to install the scheme from Spring 2026.

View the decision notice and our response to the consultation feedback.

The works are currently being installed across Bath, and you can view a construction timetable below.

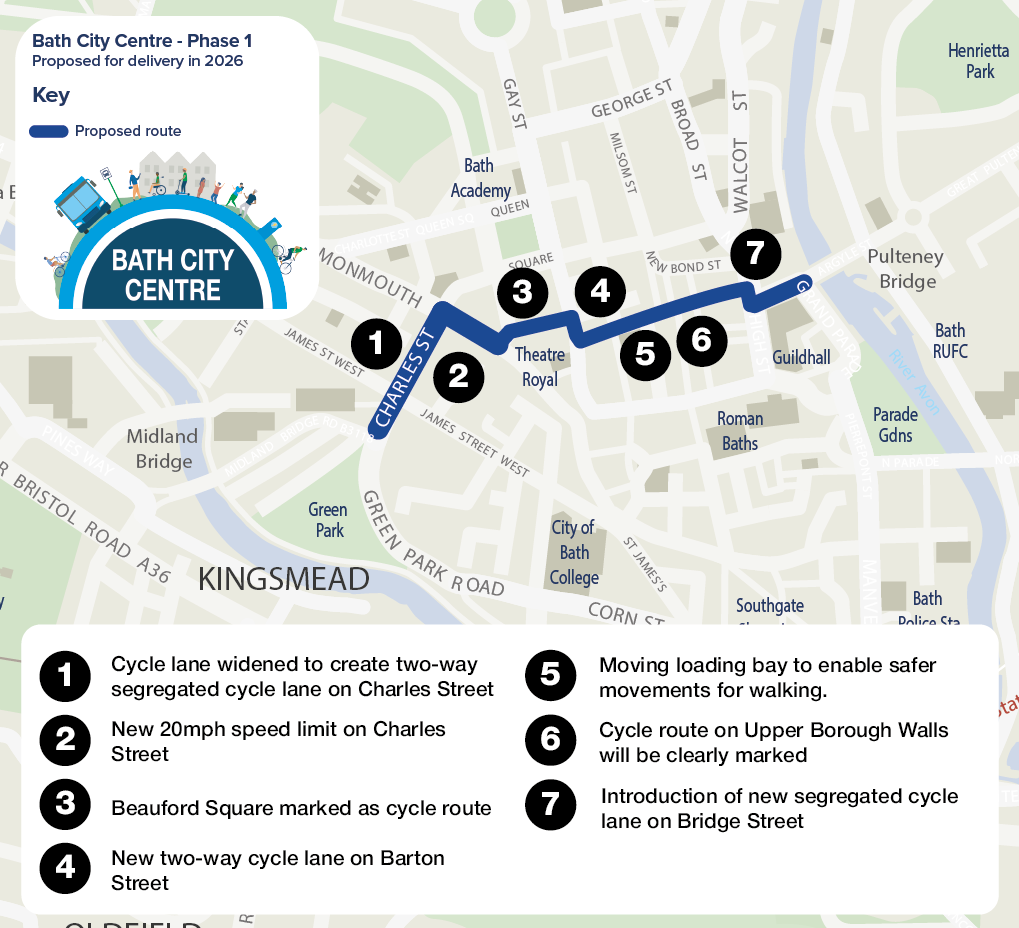

Bath City Centre – Phase 1

As part of our Corporate Strategy, we want to make walking, wheeling, and cycling safer, more convenient and accessible, while helping to reduce congestion and improve air quality.

Phase 1 focuses on better, safer and more direct routes for cyclists through the city centre – connecting to existing cycle routes.

Our current proposals affect the area highlighted in blue on this map of Bath City Centre.

Map of the proposed improvements to Bath City Centre.

Map of the proposed improvements to Bath City Centre

Our plans

We are installing new and upgraded cycle routes that connect with existing routes and other projects in development.

This includes upgrading the city-centre section of the long-distance National Cycle Network route 4 which connects the Kennet and Avon Canal and the Bristol and Bath Railway Path.

The plans change this route across the city centre, converting it into a single two-way cycle route, running between Pulteney Bridge and New King Street.

A short section of new cycle route further south along Charles Street would plug a 'missing link' connecting the existing National Cycle Network route 4 and Upper Bristol Road to the Riverside Park at Bath Quays via Green Park Road.

Our Bath Quay Links project continues the route across Bath Quays Bridge to other cycle routes in the south and east.

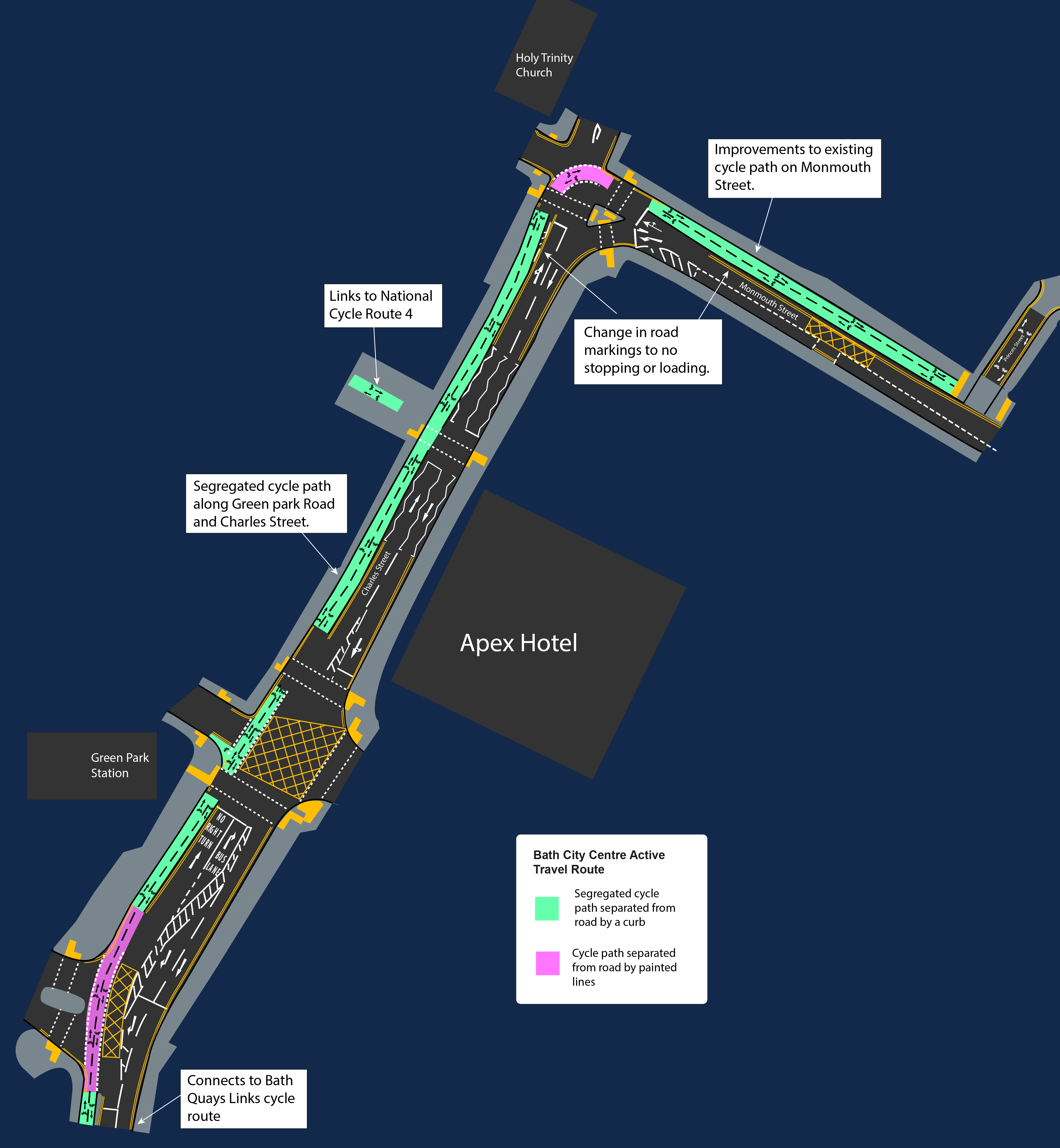

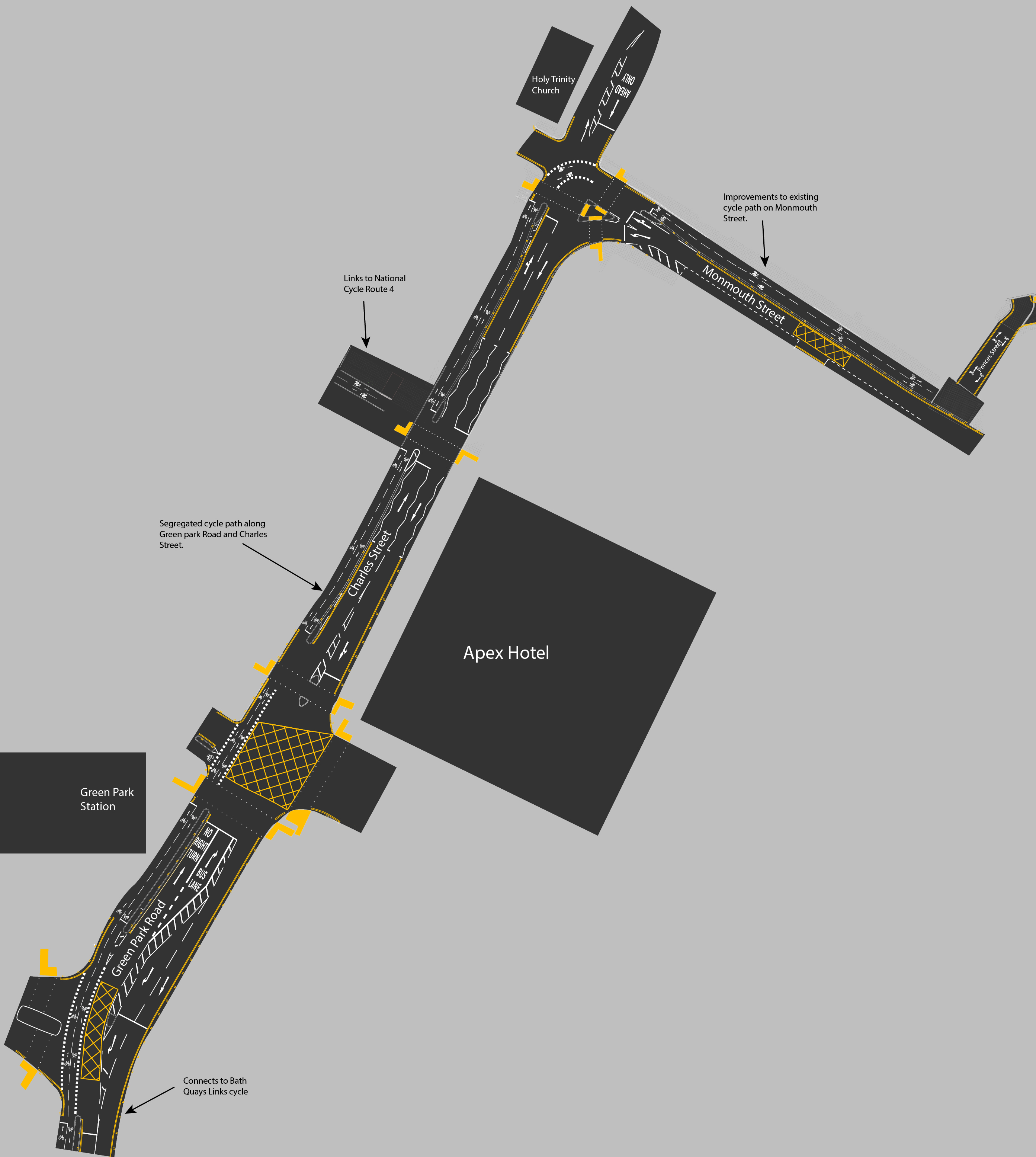

Map showing improvements on Green Park Road, Charles Street, and Monmouth Street

Map showing improvements on Green Park Road, Charles Street, and Monmouth Street

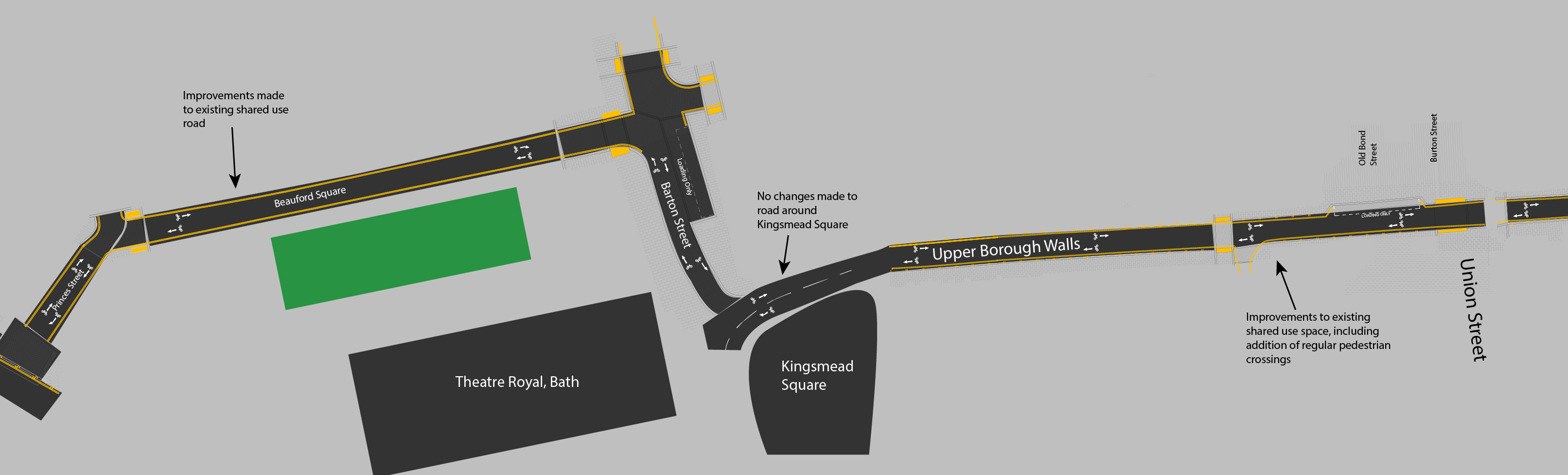

Map showing improvements on Beauford Square and Upper Borough Walls

Map showing improvements on Beauford Square and Upper Borough Walls

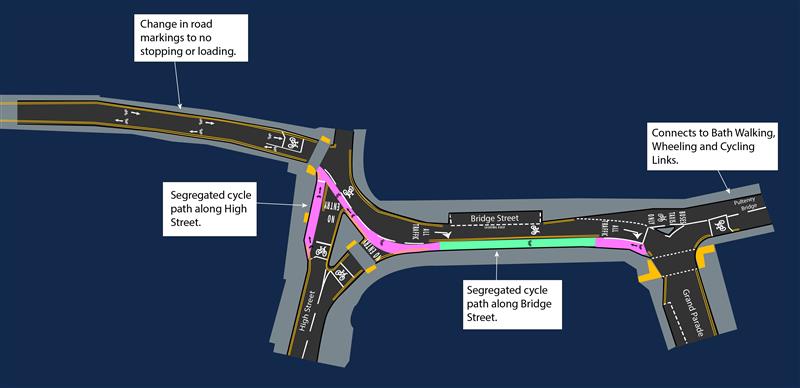

Map showing improvements on High Street and Bridge Street

Map showing improvements on High Street and Bridge Street

Construction timetable

For works in progress, view our weekly construction updates for live information.

Construction for this scheme starts in March. Efforts have been made to ensure disruption is kept to a minimum.

AreaProposed start dateDurationWorks taking placeStatus
Upper Borough WallsApril 202618 weeksNew loading bay with protective bollards, clearly marked cycle routePaused
Old Bond StreetApril 202612 weeksRepaving of areaComplete
Burton StreetApril 202612 weeksRepaving of areaComplete
Bridge Street (1)April 202618 weeksNew segregated cycle path, new loading bayComplete
Bridge Street (2)28 September to 8 November 20266 weeksAn upgraded signalised crossing at the junction of Grand Parade plus improved paving and drainage.Complete
Beauford SquareLate May 2026 Upgraded pedestrian crossings and road repavingPaused
Princes StreetLate May 2026 Upgraded pedestrian crossings and road repavingPaused
Charles StreetApril 20267 monthsSegregated cycle path linking to new cycle path on Green Park RoadIn progress
Barton StreetEarly summer 2026 Extension of pedestrianised areaPaused
Trim StreetEarly summer 2026 Upgraded pedestrianised crossings and paved areasPaused
Monmouth StreetJuly 20269 weeksNew segregated cycle lane in both directionsIn progress

Weekly construction updates

Updated 11 November 2026

Charles Street / Monmouth Street

Latest updates:

Overnight resurfacing works are now complete along Charles Street and Monmouth Street.

An extended area of Monmouth Street will be resurfaced from the Princes Street junction towards Kingsmead Square (finishing by Casa Iguanas Restaurant). These works will take place overnight from Monday 9 November to Wednesday 11 November, 11pm to 6am each night. All restrictions will be lifted by 6am on Thursday 12 November.

As part of the final phase of these works, we will resurface the junction of Charles Street/James Street West/Green Park Road. This work will take place across three consecutive nights, from Wednesday 11 November to Friday 13 November, between 11pm and 6am each night.

At the same time, resurfacing works will take place at the Green Park Road/Midland Bridge Road junction as part of the Bath Quays Links project. To help maintain the flow of traffic, works at each junction will be carried out in phases.

All restrictions will be lifted at 6am on Saturday 14 November.

During the closure hours, connecting roads, where a junction is closed, will remain open for access only.

Pedestrian access will be maintained throughout the works, and a signed diversion route will be in place for motorists.

Before travelling by bus during the closure hours, please check Travel West.

Visit Causeway one.network to view a map of works.

Upper Borough Walls

Latest updates:

  • Final works for Upper Borough Walls are deferred to 2027. Please refer back to our project web page for updates.

Bridge Street

Latest updates:

  • Overnight construction on Bridge Street is now complete as of Sunday 8 November.

How Bath City Centre connects to the wider network

Direct interfaces with:

Key benefits

  • This would create a better signposted joined-up network across the city centre – making cycling easier, safer and direct.
  • Move cyclists away from those walking on the busier shopping streets, following mostly along segregated cycle lanes or quieter streets.
  • Make cycling a more attractive option, appealing to a wide range of people.
  • Footpaths would also be improved where needed along the route.

Why walking, wheeling and cycling is important

We need to make walking, wheeling and cycling the natural choice for a lot more of our journeys. Currently, over a third of car trips across Bath and North East Somerset are less than 5km.

The importance of walking, wheeling, and cycling, or ‘active travel’ as an affordable and accessible mode of transport has become increasingly apparent over recent years.

The benefits of active travel are extensive - from improving air quality to ensuring healthier places and people. By enabling more travel options, we can optimise road space for all.

Active Travel Masterplan

Bath City Centre is part of our Active Travel Masterplan, a comprehensive plan that sets out the existing and future network of active travel infrastructure. Consultation took place during summer 2024 and aims to enable walking, cycling, and other forms of active travel, ensuring safer, healthier, and more accessible transportation options for everyone. It will support all types of journeys including commuting, education, leisure, and tourism.

View the Active Travel Masterplan consultation page to find out more.

Phase 1 Timeline

Dates and project stages
DateStage
December 2023Initial public consultation on draft proposals
2023 to 2024Scheme development and proposals refined
Summer / Autumn 2025Complete detailed design
Autumn 2025Full Business Case submitted to West of England Mayoral Combined Authority
Autumn / Winter 2025Full Business Case approval
Summer 2026Construction begins

Keep informed

To get updated about the progress of the project you can sign up to our mailing list.

You can also subscribe to our newsletter, E-connect, or follow us on X (formerly Twitter), Facebook and Instagram.

If you have feedback or questions about this scheme, please email us at bath_links@bathnes.gov.uk.

Funded by UK government

Funding secured by West of England Combined Authority
